American Triangle Reconstruction
-
100% complete
-
100% complete
-
42% complete

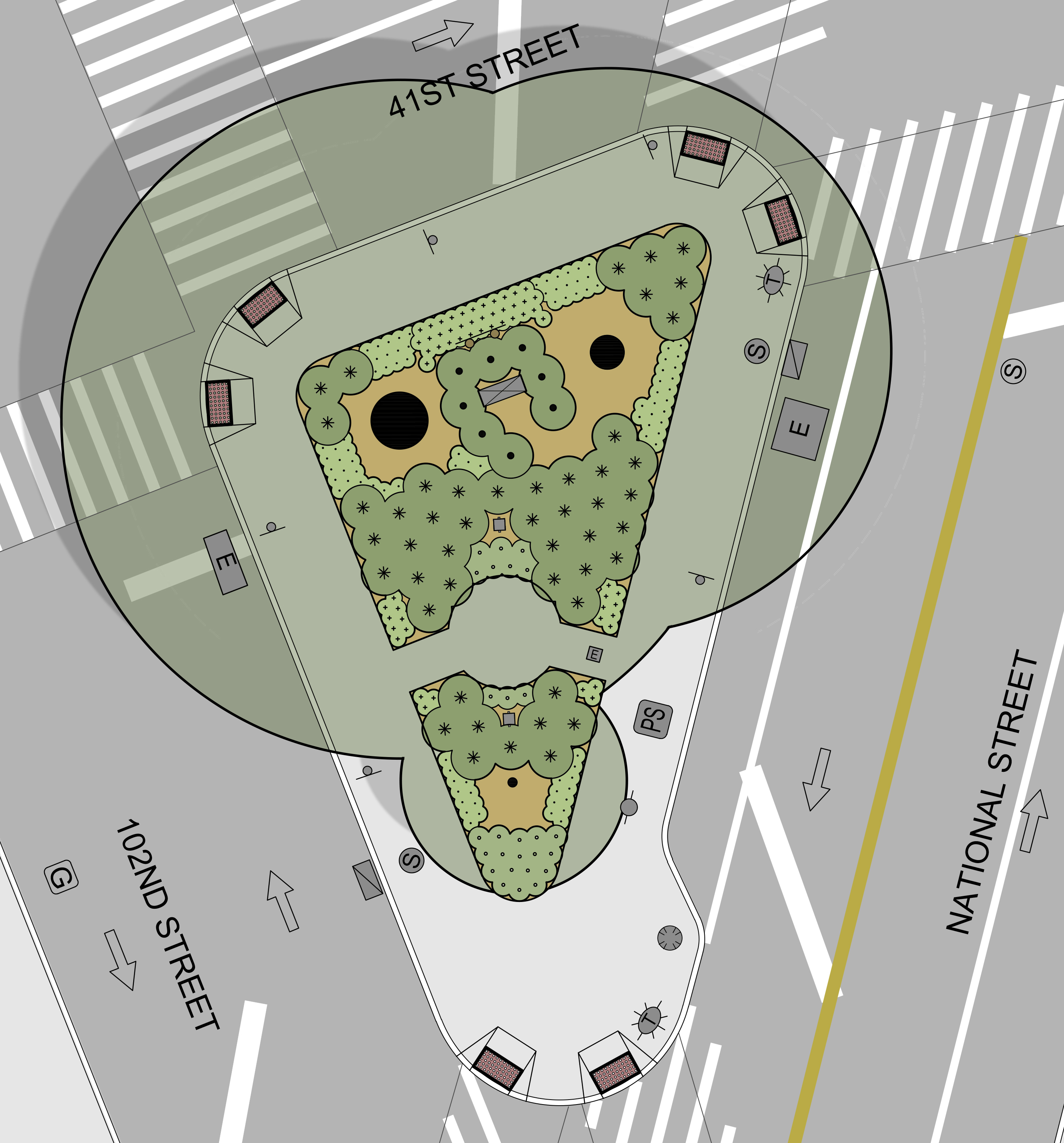

This project will reconstruct American Triangle.
Project Notes
Project Update: This project is in active construction.
The completion date has changed. To learn more about why schedules change, please visit the How We Build Parks page.
Project Timeline
Design
Assigned & Start Date: April 2022
Projected Completion Date:
April 2023
Completion Date:
May 2023
Procurement
Start Date: May 2023
Projected Completion Date:
April 2024
Completion
Date:
January 2025
Construction
Start Date: March 2025
Projected Completion Date:
March 2026
Understand how we build parks.
Funding
Funding Source: City Council
Location
American Triangle, Queens
102nd Street, 41st Avenue, National Street
Community Board: 04
Project Staff
Project Liaison: Meira Berkower
Contact NYC Parks about this project
Last updated: 06/30/2025
