Annadale Green Reconstruction
-
100% complete
-
100% complete
-
6% complete

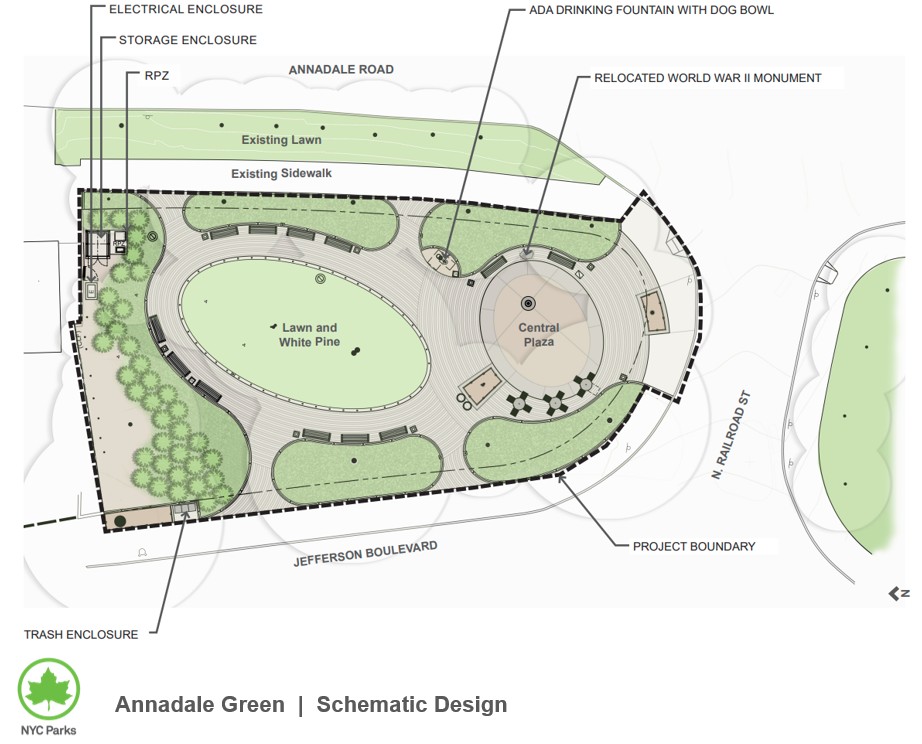

This project will reconstruct the passive park and sidewalks at Annadale Green.
Project Notes
Project Update: This project is in active construction.
The completion date has changed. To learn more about why schedules change, please visit the How We Build Parks page.
Project Timeline
Design
Assigned & Start Date: January 2023
Projected Completion Date:
January 2024
Completion Date:
January 2024
Procurement
Start Date: January 2024
Projected Completion Date:
September 2025
Completion
Date:
April 2025
Construction
Start Date: April 2025
Projected Completion Date:
April 2026
Understand how we build parks.
Funding
Funding Sources:
- Borough President
- City Council
Location
Annadale Green, Staten Island
Jefferson Boulevard and Annadale Road
Community Board: 03
Project Staff
Project Liaison: Joseph Homsey
Contact NYC Parks about this project
Last updated: 06/30/2025
