Herbert Von King Park Dog Run Reconstruction

  • Design
    50% complete
  • Procurement
    0% complete
  • Construction
    0% complete

This project will reconstruct the dog run at Herbert Von King Park.

Project Notes

The completion date has changed. To learn more about why schedules change, please visit the How We Build Parks page.

Project Timeline

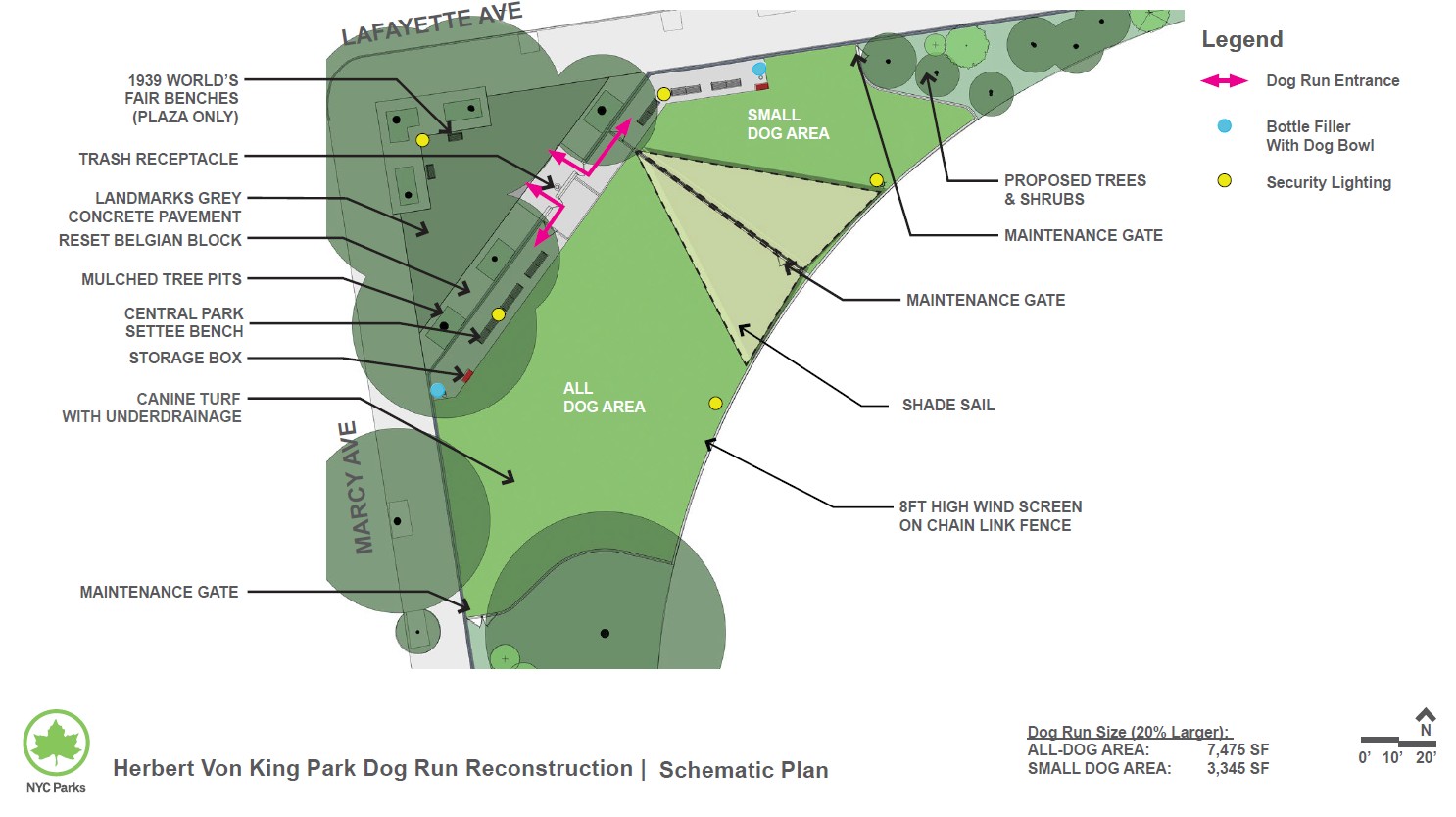

Design

Assigned & Start Date: March 2024
Projected Completion Date: March 2025
Adjusted Completion Date: September 2025

Procurement

The average time for procurement is 9-12 months. The procurement timeline for this specific contract will be established at the conclusion of the design phase.

Construction

The average time for construction is 12-18 months. The construction timeline for this specific contract will be established at the conclusion of the procurement phase.

Understand how we build parks.

Funding

Total Funding: Between $1 million and $3 million
Funding Sources:
  • Borough President
  • City Council
  • Mayoral

Location

Herbert Von King Park, Brooklyn
Marcy Avenue, Tompkins Avenue, between Greene Avenue and Lafayette Avenue
Community Board: 03



Project Staff

Project Liaison: James Morris
Contact NYC Parks about this project

Last updated: 06/30/2025
