Crocheron Park Buz O'Rourke Playground Reconstruction

  • Design
    35% complete
  • Procurement
    0% complete
  • Construction
    0% complete

This project will reconstruct the Buz O'Rourke playground at Crocheron Park.

Project Notes

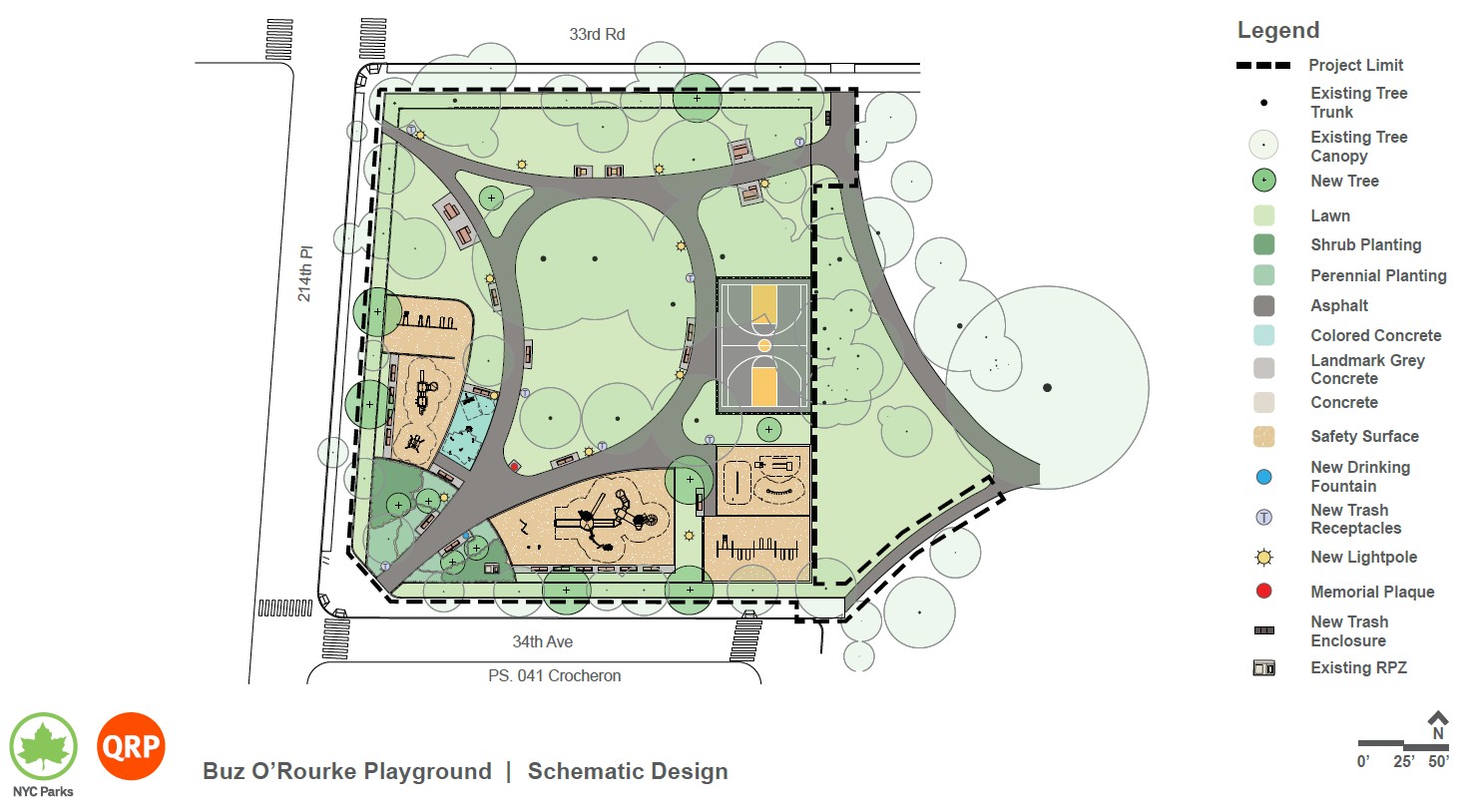

Project Update: The schematic design for this project has been approved. Parks is now developing the documents required to build this project.

Project Timeline

Design

Assigned & Start Date: November 2024
Projected Completion Date: January 2026

Procurement

The average time for procurement is 9-12 months. The procurement timeline for this specific contract will be established at the conclusion of the design phase.

Construction

The average time for construction is 12-18 months. The construction timeline for this specific contract will be established at the conclusion of the procurement phase.

Understand how we build parks.

Funding

Total Funding: Between $5 million and $10 million
Funding Sources:
  • Borough President
  • City Council

Location

Crocheron Park, Queens
At 214th Place between 33rd Road and 34th Avenue
Community Board: 11



Project Staff

Project Liaison: Meira Berkower
Contact NYC Parks about this project

Last updated: 06/30/2025
